Railway Reforms

Mumbai-Ahmedabad High-Speed Rail (MAHSR)

Why in News?

The Mumbai-Ahmedabad High-Speed Rail (MAHSR) Project, India’s first bullet train corridor, has achieved major construction milestones in 2026 and is expected to commence operations from August 2027.

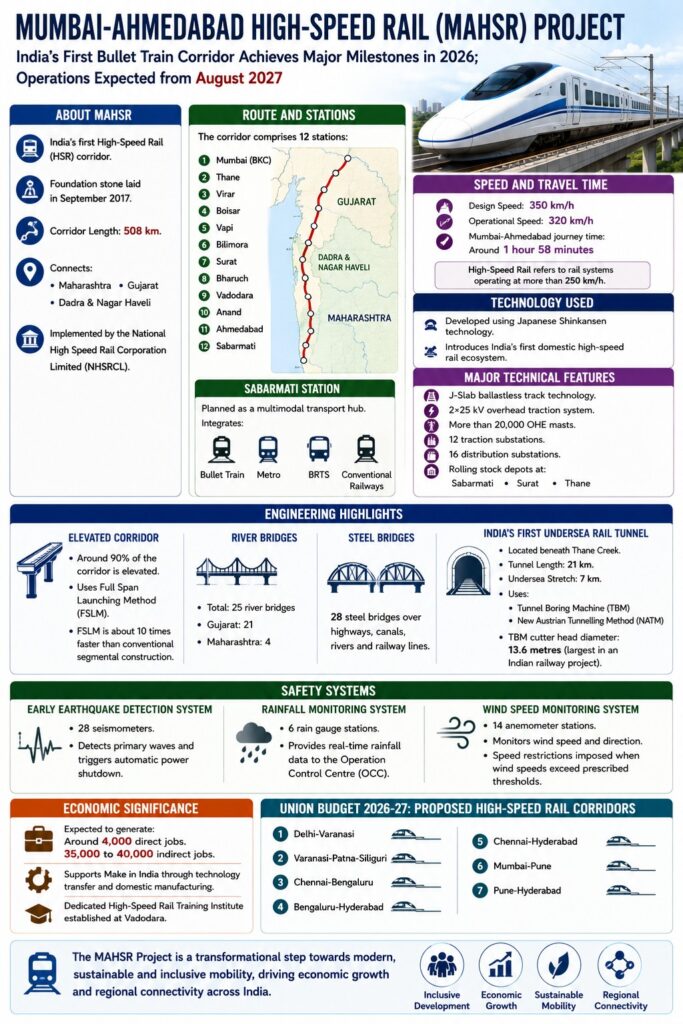

About MAHSR

  • India’s first High-Speed Rail (HSR) corridor.
  • Foundation stone laid in September 2017.
  • Corridor Length: 508 km.
  • Connects: Maharashtra, Gujarat, and Dadra & Nagar Haveli
  • Implemented by the National High Speed Rail Corporation Limited (NHSRCL).
  • The corridor comprises 12 stations
  • Sabarmati Station: Planned as a multimodal transport hub.
  • Integrates: Bullet Train, Metro, BRTS, and Conventional Railways.

Speed and Travel Time

  • Design Speed: 350 km/h
  • Operational Speed: 320 km/h
  • Mumbai-Ahmedabad journey time: Around 1 hour 58 minutes
  • High-Speed Rail refers to rail systems operating at more than 250 km/h.

Technology Used

  • Developed using Japanese Shinkansen technology.
  • Introduces India’s first domestic high-speed rail ecosystem.

Major Technical Features

  • J-Slab ballastless track technology.
  • 2×25 kV overhead traction system.
  • More than 20,000 OHE masts (Overhead Equipment Mast) is a vital vertical steel support used in railway electrification
  • 12 traction substations (electrical substation that converts power from the public electricity grid into the specific voltage, current, and frequency required to power railways, trams, or trolleybuses)
  • 16 distribution substations (electrical facility that receives high-voltage power from transmission or sub-transmission systems and “steps down” the voltage to medium levels).
  • Rolling stock depots at: Sabarmati, Surat, and Thane.

Engineering Highlights

Elevated Corridor

  • Around 90% of the corridor is elevated.
  • Uses Full Span Launching Method (FSLM).
  • FSLM is about 10 times faster than conventional segmental construction.
  • River Bridges: Total: 25 river bridges: Gujarat: 21. Maharashtra: 4.
  • Steel Bridges: 28 steel bridges over highways, canals, rivers and railway lines.

India’s First Undersea Rail Tunnel

  • Located beneath Thane Creek.
  • Tunnel Length: 21 km.
  • Undersea Stretch: 7 km.
  • Uses: Tunnel Boring Machine (TBM) and New Austrian Tunnelling Method (NATM).
  • TBM cutter head diameter: 13.6 metres (largest in an Indian railway project).

Safety Systems

  • Early Earthquake Detection System: 28 seismometers. Detects primary waves and triggers automatic power shutdown.
  • Rainfall Monitoring System: 6 rain gauge stations. Provides real-time rainfall data to the Operation Control Centre (OCC).
  • Wind Speed Monitoring System: 14 anemometer stations. Monitors wind speed and direction. Speed restrictions imposed when wind speeds exceed prescribed thresholds.

Economic Significance

  • Expected to generate: Around 4,000 direct jobs. 35,000 to 40,000 indirect jobs.
  • Supports Make in India through technology transfer and domestic manufacturing.
  • Dedicated High-Speed Rail Training Institute established at Vadodara.

Union Budget 2026-27: Proposed High-Speed Rail Corridors

  • Delhi-Varanasi, Varanasi-Patna-Siliguri, Chennai-Bengaluru, Bengaluru-Hyderabad, Chennai-Hyderabad, Mumbai-Pune, and Pune-Hyderabad

[2023] Consider the following statements :
1. In a seismograph, P waves are recorded earlier than S waves.
2. In P waves, the individual particles vibrate to and fro in the direction of wave propagation, whereas in S waves, the particles vibrate up and down at right angles to the direction of wave propagation.
Which of the statements given above is/are correct?

[A] 1 only

[B] 2 only

[C] Both 1 and 2

[D] Neither 1 nor 2
